The Underline will transform the land below Miami's Metrorail into a 10-mile linear park, urban trail and living art destination.

Vision

We are transforming the underutilized land below Miami’s MetroRail, from the Miami River to Dadeland South Station, into a 10-mile linear park, world-class urban trail and living art destination.

The Underline will connect communities, improve pedestrian and bicyclist safety, create over 120 acres of open space with restored natural habitats, encourage a healthy lifestyle, provide an easily accessible place to exercise, create a mobility corridor that integrates transit, car, biking and walking, provide a 10-mile canvas for artistic expression, attract development along US1, and generate significant economic impact.

Brickell Backyard Promenade Now

Brickell Backyard Promenade After

MPath and Transit infrastructure Now

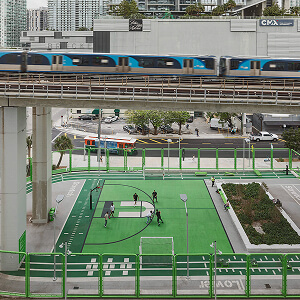

Brickell Backyard outdoor gym After

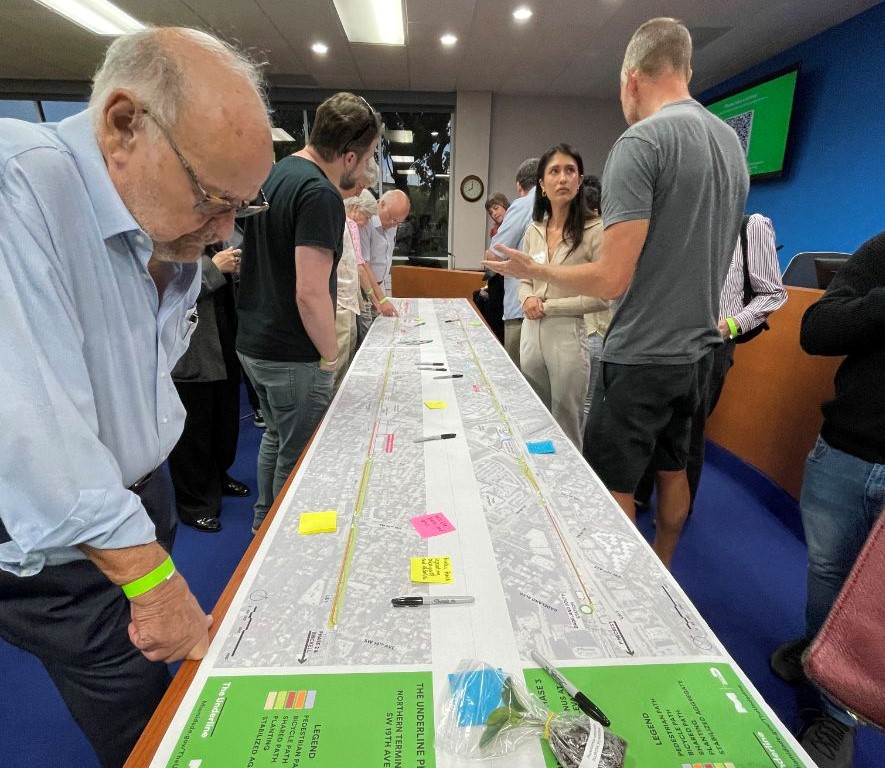

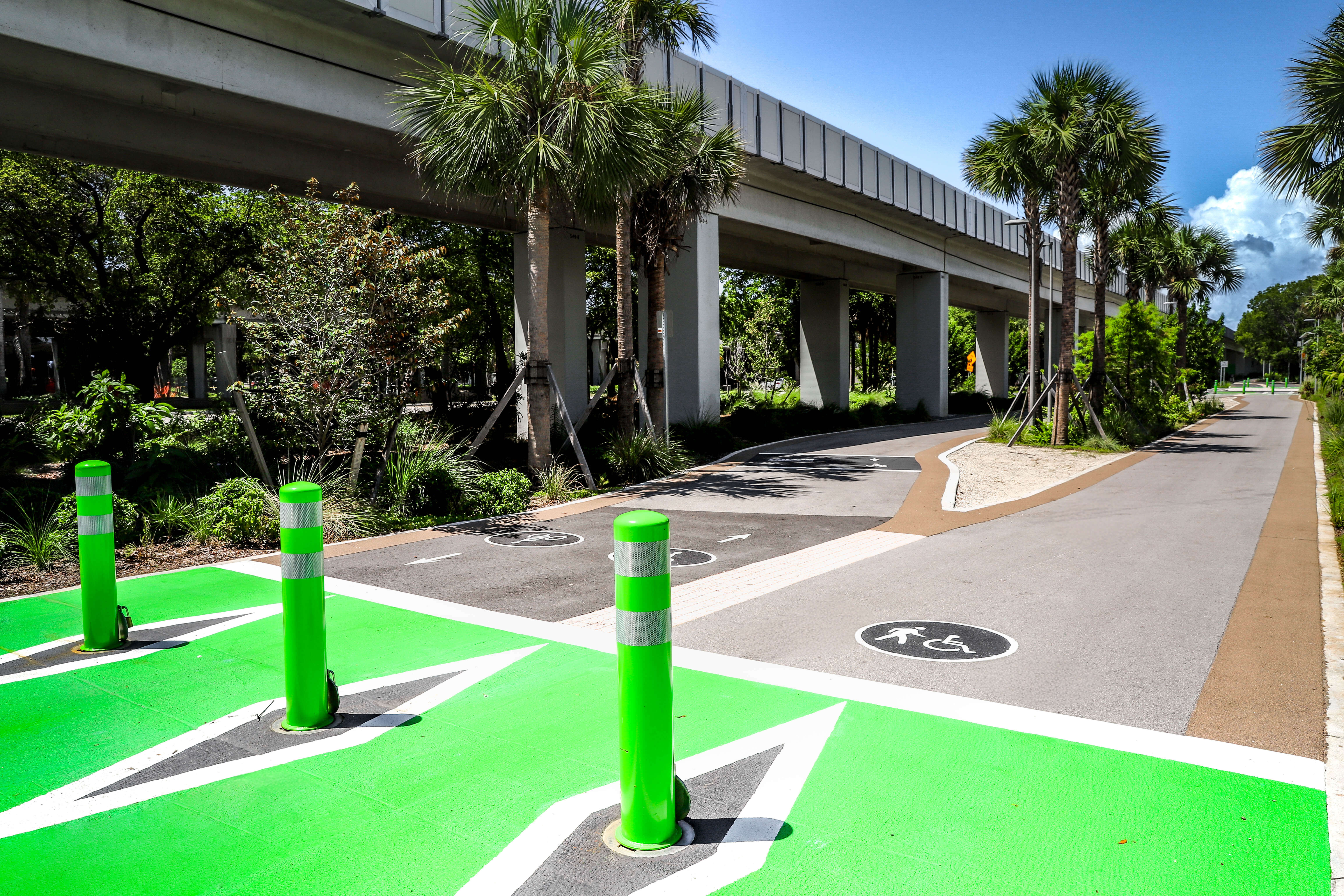

Progress

Phase 1
Brickell Backyard (Miami River to SW 13th Street)

Length: 0.5 miles
Progress: Construction begins late 2018
Total Cost:
$16 million
Funding:
CONSTRUCTION FUNDED
$7,688,760, Miami-Dade County
$1,944,000, FDOT Tap Grant
$2,000,000, State of Florida
$4,871,690, City of Miami
$19,808, FDOT

Target Construction Date:
4th Quarter 2018
Target Construction End Date:
2nd Quarter 2020

Phase 2

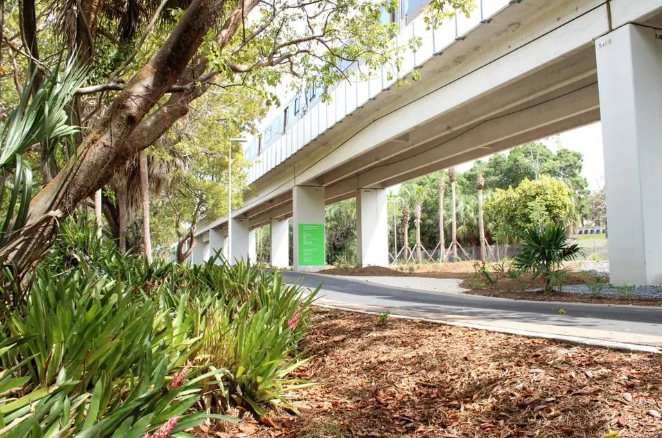

Miami (SW 13th Street to SW 19th Avenue)

Length: 2.14 miles
Progress: Pre-Design Planning
Total Cost: $18 million
Funding:
CONSTRUCTION FUNDED
$8,578,770, State of Florida
$8,000,000, Miami-Dade County
$1,747,209, City of Miami

Target Construction Date:
TBD
Target Construction End Date:
TBD

Phase 3
Miami (SW 19th Avenue to SW 23rd Avenue)

Length: 0.8 miles
Progress: TBD
Total Cost: $8.5 million
Funding:
CONSTRUCTION UNFUNDED

Target Construction Date: TBD
Target Construction End Date: TBD

Phase 4
Miami (SW 23rd Avenue to 37th Avenue)

Length: 0.92 miles
Progress: TBD
Total Cost: $14 million
Funding: TBD
CONSTRUCTION UNFUNDED

Target Construction Date: TBD
Target Construction End Date: TBD

Phase 5
Coral Gables (SW 37th Avenue to SW 42nd Avenue)

Length: 0.66 miles
Progress: TBD
Total Cost: $6 million
Funding:
SEGMENTS TO BE BUILT BY DEVELOPMENTS AT DOUGLAS STATION, THE COLLECTION, GABLES STATION

Target Construction Date: TBD
Target Construction End Date: TBD

Phase 6
Coral Gables (SW 42nd Avenue to SW 57th Avenue)

Length: 1.98 miles
Progress: TBD
Total Cost: $26.5 million
Funding:
CONSTRUCTION UNFUNDED

Target Construction Date: 4th Q 2018
Target Construction End Date: 2nd Q 2020

Phase 7
South Miami (SW 57th Avenue to SW 65th Avenue)

Length: 1.14 miles
Progress: TBD
Total Cost: $15 million
Funding:
CONSTRUCTION UNFUNDED

Target Construction Date: TBD
Target Construction End Date: TBD

Phase 8
Miami-Dade County (SW 65th Avenue to Dadeland South)

Length: 1.16 miles
Progress: TBD
Total Cost: $17 million
Funding:
CONSTRUCTION UNFUNDED

Target Construction Date: TBD
Target Construction End Date: TBD

Join

Be a Friend
Join now to be a Friend of The Underline to get updates on events and other important news.

I'm interested in volunteering

Friends of The Underline

Friends of The Underline is a 501(c)3 nonprofit organization transforming the underutilized land below Miami’s Metrorail into a 10-mile neighborhood park, multi-modal, world-class, urban trail and canvas for artistic expression to create a safer, healthier, more connected, mobile and engaged community.

The Underline will be open to all and serve all with amenities and art that will connect people to place and each other.

Path Board of Directors

  • Meg Daly Founder and President
  • Roger Terrone Treasurer, Chair Finance & Governance Committee
  • Arden Karson, Chair Development Committee
  • Jessi Berrin, Chair Health Advisory Committee
  • Kieran Bowers
  • Nick D'Annunzio, Marketing Committee
  • Emily Estefan
  • Alfred Lurigados, Chair Transportation Committee
  • Arturo Nuñez
  • David Martin, Chair Real Estate Council
  • Josh Merkin, Chair Marketing & Outreach Committee
  • Camilo Miguel, Jr.
  • Brent Reynolds, Chair Real Estate Committee
  • Debi Wechsler, Chair Art Advisory Committee
  • Lilly Weinberg
  • Steven Wernick
  • Eric Zichella, Chair of Advocacy
  • Parker Thomson, Honorary Board Member
  • BOARD OF TRUSTEES
  • Brian Keeley, Baptist Health South Florida
  • Stephen Owens, Swire Properties
  • Jorge Plasencia, Republica
  • Donna Shalala, University of Miami
  • Louis Wolfson, Pinnacle Housing
  • Judy Zeder, EWM

Path Public Funders & Sponsors

  • Miami-Dade County
  • State of Florida
  • City of Miami
  • Florida Department of Transportation
  • City of Coral Gables
  • City of South Miami

Path Underline and Brickell Backyard Founders

  • Swire Properties, Underline Founder
  • The John S. and James L. Knight Foundation, Underline Founder
  • Pinnacle Housing Group, Brickell Backyard Founder
  • Publix Charities, Brickell Backyard Founder
  • Banyan Street Capital, Brickell Backyard Founder
  • Mary Brickell Village, Brickell Backyard Founder
  • Brickell Heights & SLS Lux, Brickell Backyard Founders

Path Donors & Supporters

  • ArtPlace America
  • Hogan Lovells
  • University of Miami School of Architecture
  • Florida Blue
  • Miami Foundation
  • The Mitchell Wolfson Foundation
  • NP International
  • Balfour Beatty
  • Berkowitz Development Group
  • Frank & Zully Castro
  • Hotel Atton
  • Comras Company
  • GSK Advisors
  • 13th Floor/Adler Group
  • Health Foundation of South Florida
  • Meg & John Daly
  • SoMi Magazine
  • Leslie Miller Saiontz
  • Cowles Charitable Trust
  • People for Bikes
  • rbb Communications
  • TaraInk
  • Baptist Health South Florida
  • Hotel Atton
  • Le Parc at Brickell
  • Related's Brickell Heights
  • Parker Thomson
  • Debi Wechsler
  • The Clinton Family Fund
  • Health Foundation of South Florida
  • Roger Terrone
  • Fine & Greenwald Foundation
  • Rails to Trails
  • Greenberg Traurig

Path Partners

  • The High Line Network
  • Miami-Dade County Transportation & Public Works Department
  • Miami-Dade County Parks, Recreation & Open Spaces Department
  • University of Miami School of Architecture
  • The John S. and James L. Knight Foundation
  • The Miami Foundation
  • SOMI Magazine

Path Endorsements

  • Miami-Dade County
  • City of Miami
  • City of Coral Gables
  • City of South Miami
  • Beacon Council
  • ChamberSOUTH
  • Coral Gables Chamber of Commerce
  • Village of Pinecrest
  • Village of Palmetto Bay
  • AIA Miami Chapter
  • APA FL Gold Coast Section
  • Bakehouse Art Complex
  • Baptist Health South Florida
  • BDO
  • Beacon Council
  • Bike Coconut Grove
  • Bike SoMi
  • Bike Walk Coral Gables
  • Bike 305
  • Bottle & Bottega
  • Brickell Homeowners Association
  • Building.co
  • Coconut Grove Village Council
  • Coral Gables Chamber of Commerce
  • The Downtown Development Authority
  • East Coast Greenway Alliance
  • Emerge Miami
  • Fairchild Tropical Botanic Garden
  • Florida Department of Transportation
  • Friends of the Ludlam Trail
  • Friends of the MPath
  • Gridics
  • Hogan Lovells
  • The League of American Bicyclists
  • Lowe Art Museum
  • Mack Cycle & Fitness
  • Magic City Bicycle Collective
  • MIAMI Association of REALTORS
  • Miami-Dade County MPO BPAC
  • Miami-Dade County MPO TARC
  • The Mitchell Wolfson Foundation
  • Netherlands Consulate General In Miami
  • PeopleForBikes
  • Perricone's Restaurant
  • Republica
  • rbb Communications
  • South Miami Hospital
  • U.S. Representative Ileana Ros Lehtinen
  • Riviera Neighborhood Association (RNA)
  • Salazar Jackson LLP
  • South Miami Bike Shop
  • Swire Properties
  • The Sierra Club Miami Group
  • Tara Ink
  • TrAC
  • University of Miami
  • Vizcaya Museum & Gardens

FAQ

Where did the idea of The Underline come from?

Friends of The Underline founder, Meg Daly, broke both of her arms in 2013. Since she could not drive and had to go to physical therapy, she took the Metrorail near her home and walked underneath the train tracks to her destination. Even in July, she did not feel hot in the shade of the tracks. She also noticed how wide the corridor is and that she was the only person using it. At that moment is when she thought the land could better be utilized as a linear park and urban trail.

Who is the professional masterplan design team and how were they selected?

Through a competitive process, James Corner Field Operations (JFCO) was selected as the master plan design team from a field of 19 applicants. This team has created a master plan framework and detail for two demonstration projects. The companies working in collaboration with JFCO include Fairchild Tropical Botanic Garden, Kimley-Horn, HR&A Advisors, HLB Lighting and Pentagram.

Who is making The Underline happen?

Friends of The Underline are advocating for the transformation of the land below Metrorail from the Miami River to Dadeland South. The Friends group is working with County agencies (both Miami-Dade Parks, Recreation & Open Spaces and Transportation & Public Works departments) to raise government grants, including county, state and federal. All in the while, Friends of The Underline works to secure municipal and public funding. The management and programming of The Underline will be run by a 501C3 represented by the County, FDOT, FTA (Federal Transit Authority), Friends of The Underline and three municipalities.

Why is The Underline only being built to the south?

The area underneath the Metrorail from the Miami River to Dadeland South (the footprint for The Underline) has one owner and is continuous. Once over the river, the area under Metrorail is much more complicated due to land ownership, right of ways, etc. We are mapping how to get over the river, and connect north, west and east access points once The Underline is built.

Why is The Underline being built in phases and not all at once?

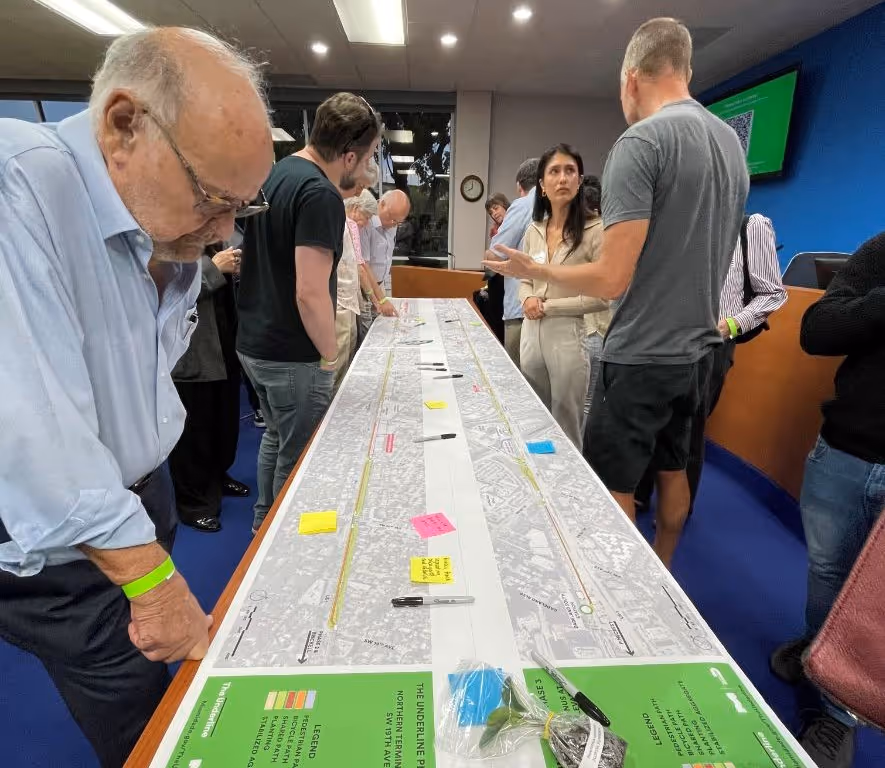

The Underline is being built in phases based on funding and to have the least amount of impact to users of the existing path.

What is the total budget for The Underline's design and implementation?

The total cost is $110-$120 million which includes:
$80 million for the two trails, lighting, seating and other amenities.
$20 million for intersections improvements (over 30 intersections).
$20 million for destination parks.

How will the project be funded?

Some of our funders include the cities of Miami, Coral Gables, and South Miami and the John S. and James L. Knight Foundation, the Miami Foundation, the Health Foundation of South Florida and Mitchell Wolfson Foundation. For a better breakdown of funding by phase, please refer to our Progress page. Additional funding will derive from public and private sources.

Do you disclose Friends of The Underline financial activities?

Yes, Friends of The Underline is a 501C3 non-profit organization and our most recent 990 Form can be found here and the most recent financial statements can be found here.

Where will my donations go?

Your donations will be used to help Friends of The Underline advocate and promote The Underline and administrate our organization. We are a 501C3 non-profit organization and your donations are tax-deductible. We really appreciate your support!

How can I donate?

Donating to The Underline is simple. You can donate online at or send a check made out to Friends of The Underline and mailed to Friends of The Underline, 1172 South Dixie Highway, #559, Coral Gables, FL 33146. Every tax deductible dollar you donate will help us maintain and manage The Underline and will contribute to a safer and more beautiful Miami. If you have questions, please contact Amy Rosenberg at 305-610-8091 or amy.rosenberg@theunderline.org.

How do I honor or memorialize my loved ones by naming something for them in the park?

We have naming opportunities starting at $1000 and welcome your support. For more information, contact Amy Rosenberg at 305-610-8091 or amy.rosenberg@theunderline.org

When will construction begin?

Construction for Brickell Backyard (Phase 1, Miami River to SW 13th St.) is projected to begin in November 2018 and Phase 2 (SW 13th St. to SW 19th St.) is projected to begin in Spring 2019. To stay up to date with construction progress, please refer to our Progress page.

Will The Underline and M-Path be closed until the entire project is built?

Access to the M-Path will be accessible as the phases are being built, some detours might occur. The Underline will be open as each phase is completed.

How long will it take to finish The Underline? Each phase?

Projects with similar vision and scope have taken a decade to complete. We project each phase taking a year to a year-and-a-half to complete. You can help us build it in less time by supporting the initiative and donating to the cause.

What are you doing about safety for bicyclists and pedestrians?

User safety is one of our biggest concerns. Currently the MPath, the bike path underneath the Metrorail, has limited lighting or amenities, and needs wider and safer crosswalks. All of these, and other safety issues, are being addressed.

What does security look like on the future Underline?

The Underline will include ample lighting, patrolling security, and CC cameras along the trail.

What are you doing about the homeless population currently using the MPath?

The Underline and it’s fixtures have been designed to prevent sleeping on the property. In addition, security will be patrolling the trails to ensure management and maintenance protocols are enforced.

How will The Underline be maintained?

Management, maintenance and programming will be done by a public 501C3.

What types of programming and amenities will be available once The Underline is built?

We used the 10 mile length of the corridor (52,800ft) multiplied by 100 feet (average width of the corridor as determined by Miami-Dade County Transit) is 121.21 acres. This is an estimate of the entire corridor including intersections. Along the estimated 100 acres, the linear park and urban trail will include butterfly gardens, dog parks, work out armatures, basketball court, mini-soccer pitch, sound stages and monumental art. The Underline will include numerous health, meditation, children, dog, art and environmental programming throughout the year.

Will there be WiFi?

Plans are in the works to include WiFi along The Underline.

Will there be bathrooms?

Bathrooms are not in the design scheme of the masterplan. The Underline is adjacent to many commercial establishments that provide easily accessible public bathrooms and are available inside Metrorail stations for riders.

I have an idea for The Underline. How do I send it to you?

One of our top priorities is getting the community involved! Please email us at info@theunderline.org with your design comments or post on our social platforms Facebook, Instagram or Twitter @theunderlinemia.

Friends of the Underline Public Documents

The Underline

Financials
